Category

Uncategorized

What is an EPD? A Practical Guide for Architects

WindowMaster actuator EPD cover among architectural drawings on a desk

What is an EPD and Why Does It Matter for Your Next Green Building Specification?

More specifications and tender schedules now include a line asking for Environmental Product Declarations. It is easy to treat that line as a tick-box: the supplier says yes, a PDF is attached, and the specification moves on.

The problem is that two EPDs can look identical on a submittal register and tell you very different things. One might cover the exact product you specified. Another might cover a related product range, report results per kilogram rather than per item, or leave out the stages of the life cycle your sustainability consultant needs.

This article explains what an EPD is and how it differs from other documents that often arrive alongside it. It also explains how to read one, and what to check before you rely on it. We use WindowMaster’s published EPDs for its window actuators and control products as a worked example, because they show clearly where the useful detail sits.

What an EPD actually is

An Environmental Product Declaration is an independently verified document that reports the environmental impacts of a product across defined stages of its life cycle. The figures come from a life cycle assessment (LCA) carried out to set rules.

For construction products, two standards set the framework. ISO 14025 sets out how this type of declaration works. EN 15804 sets the core rules for construction products specifically. Because every manufacturer follows the same rules, EPDs have a consistent structure from one manufacturer to the next.

Two points are worth being clear on.

An EPD is not a rating, a certification or a claim that a product is environmentally preferable. It is a disclosure. A product with a high carbon footprint can have a perfectly valid EPD.

An EPD also reports more than carbon. Global warming potential is the figure most people mean by embodied carbon. It sits alongside other indicators such as ozone depletion, acidification, eutrophication, resource and water use, and waste.

Product-specific and industry-average EPDs

EPDs come in two broad types.

A product-specific EPD is published by one manufacturer and reports results for products it names. The figures reflect that manufacturer’s materials, suppliers and production site.

An industry-wide or industry-average EPD is published by a group of manufacturers of similar products. It represents a typical product from that sector rather than any one manufacturer’s product.

Industry-average EPDs are useful early in design, when the product has not yet been selected. Once a specific product is specified, a product-specific EPD gives a more accurate picture, and rating tools can treat the two types differently. The EPD itself will state which type it is, usually on the first or second page.

What an EPD is not

Several other documents can arrive in the same submittal package. They answer different questions, and confusing them is one of the most common sources of rework at approval stage.

Declaration of Performance

On European-made construction products, a Declaration of Performance (DoP) states how a product performs against the essential characteristics of a harmonised technical standard. For a natural smoke and heat exhaust ventilator, for example, that can include aerodynamic free area, reliability, resistance to heat, and wind and snow load.

A DoP is about technical performance. An EPD is about environmental impact. A product can have one without the other, and neither substitutes for the other in a specification.

Ecolabels

An ecolabel assesses a product against a set of criteria and, if the product meets them, awards a label. It is a pass or fail judgement made by the label’s operator.

An EPD makes no such judgement. ISO 14025 classifies EPDs as Type III environmental declarations: quantified data, independently verified, with interpretation left to the reader. Some ecolabels use EPD data as part of their assessment, but holding an EPD does not mean a product holds an ecolabel.

Carbon-neutral claims

A carbon-neutral claim generally relates to whether a product’s emissions have been offset. An EPD reports the emissions associated with the product and makes no claim about offsetting. If a project needs embodied carbon figures for an assessment, the EPD is the relevant document.

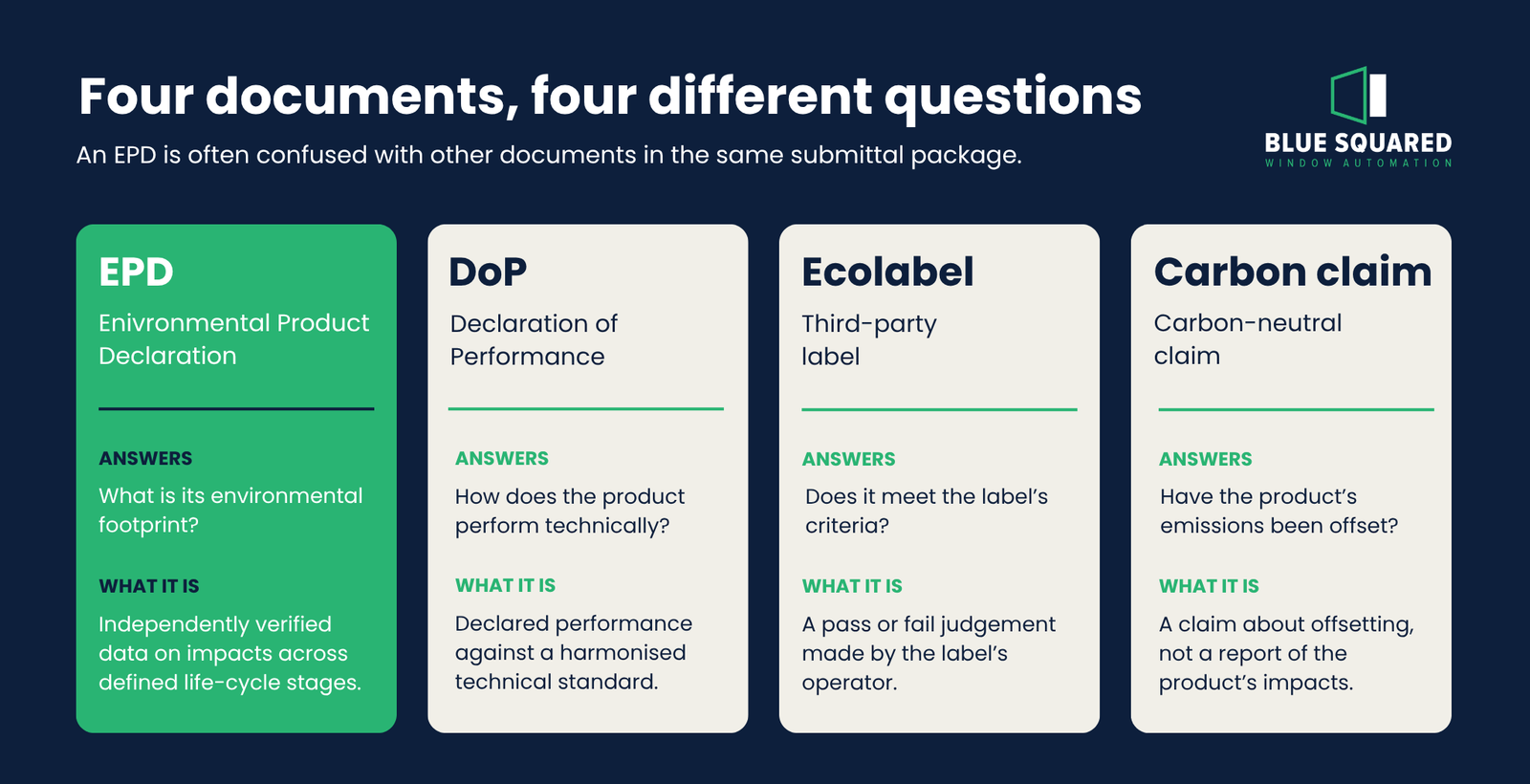

Comparison of an EPD, Declaration of Performance, ecolabel and carbon-neutral claim

Reading an EPD: a worked example

WindowMaster publishes two current EPDs relevant to automated windows:

  • The first covers its actuators.
  • The second covers control panels, keypads, an indoor room sensor, and wind and rain sensors.

Both were issued in September 2023 under the EPD Danmark program. Both were verified by an external third party and prepared to EN 15804+A2.

Working through them shows the five things to check in any EPD.

1. Which products does it cover?Chain of a WindowMaster actuator on an open commercial window

An EPD applies only to the products it names. The WindowMaster actuator EPD groups its results into large, medium and small actuators and lists the specific model families within each group. The controls EPD lists the control panels, keypads and sensors it covers.

If the product in your specification is not named in the declaration, the EPD does not cover it, however similar the product looks. Matching model numbers between the specification and the EPD is the simplest check. It is also the check most often skipped.

2. What is the declared unit?

Every EPD reports its results against a declared unit. This is where like-for-like comparisons most often go wrong.

The WindowMaster actuator EPD reports results per 1 kg of actuator, whatever the size of the actuator. The controls EPD reports results per piece.

A per-kilogram result is not the impact of one actuator. To use it, your sustainability consultant needs the weight of each actuator and the quantity on the project. The controls EPD also notes that the results for individual products need to be added together to understand the impact of a complete system. That makes the project’s schedule of actuators and controls as important as the EPD itself.

3. Which life-cycle stages are included?

EN 15804 divides a product’s life into modules:

  • A1 to A3: the product stage, covering raw materials, transport to the factory and manufacturing.
  • A4 to A5: transport to site and installation.
  • B1 to B7: the use stage, including maintenance, replacement and operational energy.
  • C1 to C4: end of life, covering dismantling, transport, waste processing and disposal.
  • D: potential benefits beyond the product’s life, such as recycling and energy recovery.

The WindowMaster EPDs declare A1 to A3, C1 to C4 and D. Modules A4, A5 and B1 to B7 are marked as not declared.

That has practical consequences. Shipping to Australia and installation are not in the figures, so any project assessment that needs those stages will have to model them separately.

It also means the EPD says nothing about what an automated window does once it is operating. The role of actuators and controls in a natural-ventilation or mixed-mode strategy sits in the use stage, which these EPDs do not cover. An EPD describes the product’s footprint. It does not measure the building performance the product is part of.

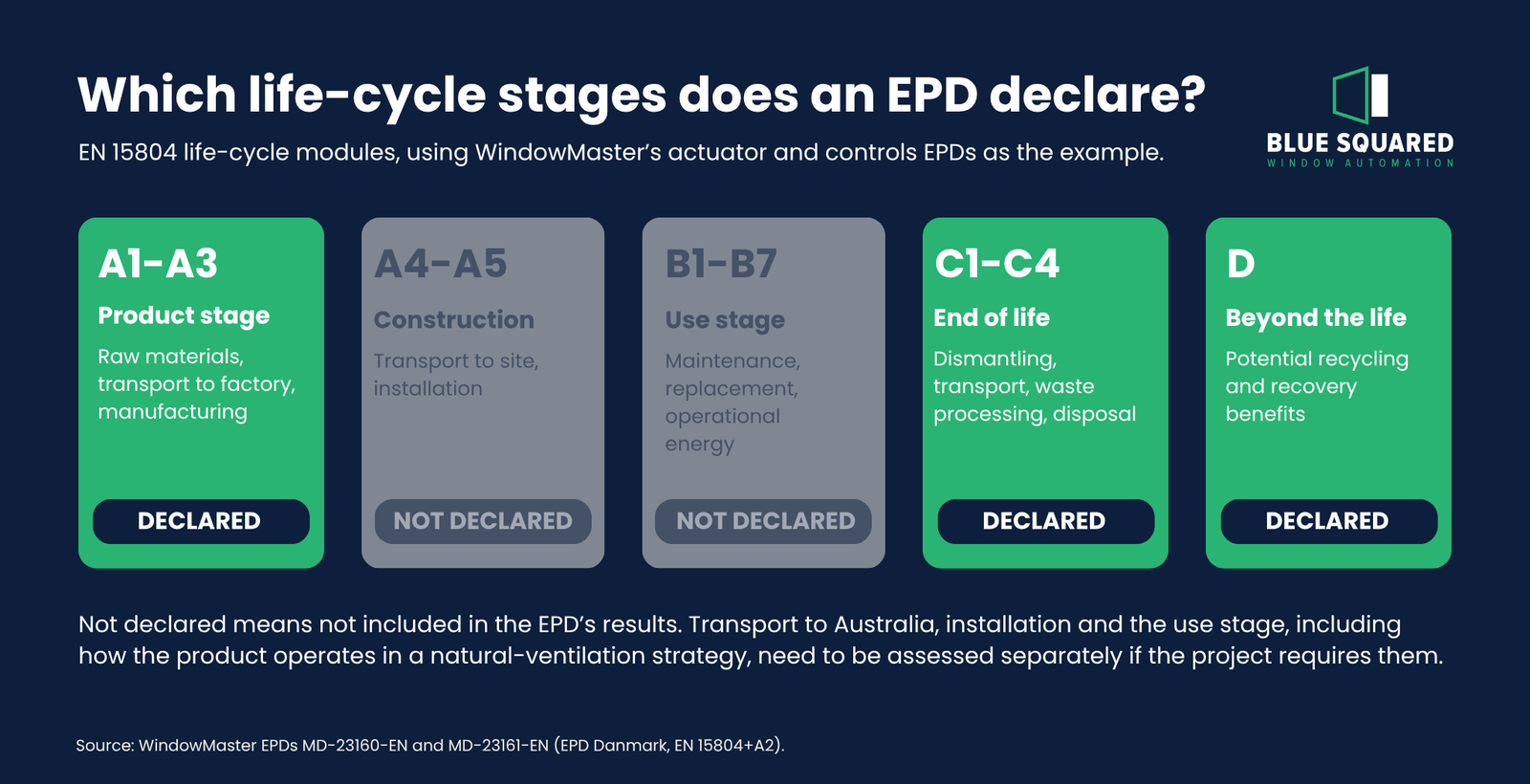

EN 15804 life-cycle modules in an Environmental Product Declaration, showing declared and undeclared stages

4. Is it current?

EPDs are time-limited. The WindowMaster EPDs state that they are valid for five years from their issue date of 8 September 2023, which takes them to 8 September 2028.

An expired EPD may still be informative, but it may not be accepted for a rating-tool submission. Check the validity date when the EPD is submitted, not just when it is first requested.

5. Can it be compared with other EPDs?

Not automatically. The WindowMaster EPDs themselves note that EPD data may not be comparable unless the EPDs comply with EN 15804 and use the same background databases.

Different declared units, different product category rules and different background data can all make a direct comparison misleading. Where comparison matters, it is a job for the project’s sustainability consultant rather than a side-by-side reading of two headline numbers.

What the interpretation section tells you

Most EPDs include a short interpretation of their own results, and it is often the most useful page for a designer. WindowMaster’s EPDs identify bought-in components and electrical parts, such as circuit boards and cables, as significant contributors. For actuators, metal parts are the largest contributor. The EPDs also note that long transport distances from Asia are significant for some indicators, while the assembly stage itself generally is not.

That kind of detail helps a project team understand where a product’s footprint comes from, rather than treating the result as a single number.

Finding and checking an EPD

Every EPD is published under a program operator, the organisation that manages the rules, verification and publication. EPD Australasia and EPD Danmark are two examples. Program operators generally maintain online registries where published EPDs can be searched.

Each EPD also carries a unique declaration number. WindowMaster’s actuator EPD, for example, is MD-23160-EN. Recording that number in the specification or submittal register makes it easy to confirm later that the document provided is the one that was reviewed.

A few quick checks will catch most problems:

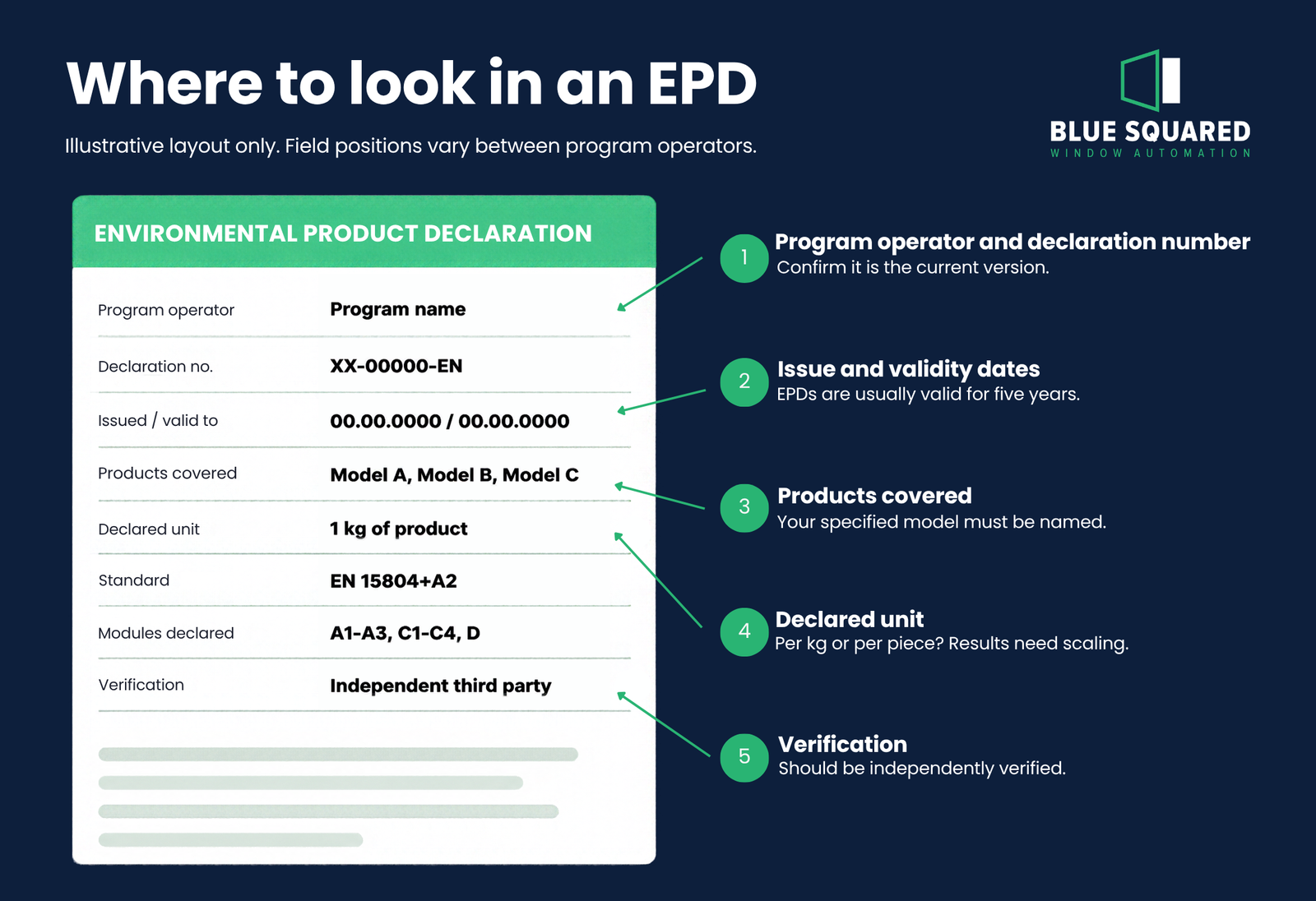

  • Confirm the declaration number, issue date and validity date on the document itself.
  • Where possible, check the EPD against the program operator’s registry or the manufacturer’s current publication.
  • Look for signs of a superseded version. Older declarations can still circulate online, so a PDF found through a search engine is not necessarily the current one.
  • Confirm the EPD states that it was independently verified, and by whom.

Annotated example of an EPD front page showing declaration number, validity date and declared unit

Why EPDs matter on Australian projects

Embodied carbon is now part of how many commercial and institutional projects are assessed, and EPDs are the main source of verified, product-level data for that work.

Rating tools also recognise them. Under the Green Building Council of Australia’s Responsible Products Framework, product-specific EPDs contribute to a product’s Responsible Product Value in the Green Star Buildings rating tool.

How a particular EPD counts depends on the rating tool version and the credit. In some cases it also depends on the program under which the EPD was published. Those details should be confirmed with the project’s ESD consultant before an EPD is relied on for a credit.

Where EPDs fit in a whole-of-building assessment

An EPD is an input, not an answer. On projects with embodied carbon targets, the ESD consultant typically builds a whole-of-building life cycle assessment. That assessment uses EN 15978, the building-level counterpart to EN 15804. Product EPDs supply the data for individual materials and components within that model.

That has a few implications for designers.

The consultant needs EPD data in a form they can scale. A per-kilogram result needs weights. A per-piece result needs counts. Neither is useful without the project’s quantities.

Gaps in an EPD have to be filled somehow. Where a module is not declared, or no product-specific EPD exists, the consultant will usually substitute generic data or an industry-average EPD. Knowing early which products have EPDs, and what those EPDs cover, reduces the number of assumptions in the final assessment.

Upfront embodied carbon usually comes first. It covers modules A1 to A3 and is the scope most often reported early in a project. Because EPDs report A1 to A3 consistently, it is usually the first part of the data to be used.

Practical steps for specifiers

EPDs are most useful when they are dealt with while the specification is being written, not chased at submittal stage. A few habits make a real difference:

  • Name the products. Specify model numbers clearly so they can be matched against the products listed in the EPD.
  • Ask early. Request EPDs during design development so your ESD consultant can confirm whether they suit the project’s assessment method.
  • Supply the quantities. Where results are per kilogram or per piece, the sustainability consultant will need weights and quantities from the system schedule.
  • Check the modules. Confirm the declared stages match what the project assessment requires, and flag any gaps early.
  • Check the dates. Record the EPD validity date and recheck it before final submission.

For automated windows and louvres, this ties naturally into the wider coordination of the system. The actuator and control schedule that defines how openings will operate is also the schedule that makes the EPD usable.

Questions to ask a supplier

These questions can be put to any supplier in an RFI, or adapted into a specification clause:

  1. Is there a current, independently verified EPD for each product being proposed? Please provide the declaration number for each.
  2. Is each EPD product-specific or industry-average?
  3. Which products and model numbers does each EPD cover?
  4. What is the declared unit, and can you provide the product weights or quantities needed to apply it?
  5. Which life-cycle modules are declared?
  6. Under which program operator was the EPD published, and to which version of EN 15804?
  7. When does each EPD expire, and is a revision planned?

A supplier who can answer these clearly is giving the project team data it can actually use.

Conclusion

An EPD is valuable because it is specific: specific products, a specific declared unit, specific life-cycle stages and a specific validity period. Read with those limits in mind, it gives architects and sustainability consultants verified data they can build into a project assessment. Read as a green tick, or mistaken for a performance declaration or ecolabel, it can create false confidence.

The best time to check those details is before the specification is issued.

Need EPD documentation for a project? As the exclusive Australian distributor for WindowMaster, Blue Squared can provide EPD documentation for WindowMaster actuators and control products on request. Contact us at sales@bluesquared.com.au, ideally while the automated openings are still being specified.
